$
ForHomely
Deal Analysis & Real Estate Metrics

How to Budget for Capital Expenditures (CapEx) in Pre-1980 Duplexes

8 min read · February 2, 2026

Operating expenses keep a property running; capital expenditures (CapEx) keep a property alive. Roofs, boilers, and sewer lines do not appear in any month's budget — they arrive as $8,000-$25,000 surprises. On pre-1980 buildings, the difference between a cash-flowing duplex and a money pit is almost always the quality of your CapEx reserve planning.

CapEx vs. Repairs: The Line

  • Repair (expense): restores an item to working order — fix a leaking faucet, patch drywall, replace a broken window pane. Deductible this year.
  • Capital improvement (CapEx): replaces or substantially improves an asset with a useful life beyond one year — new roof, new boiler, new windows. Depreciated over time (see our depreciation guide).

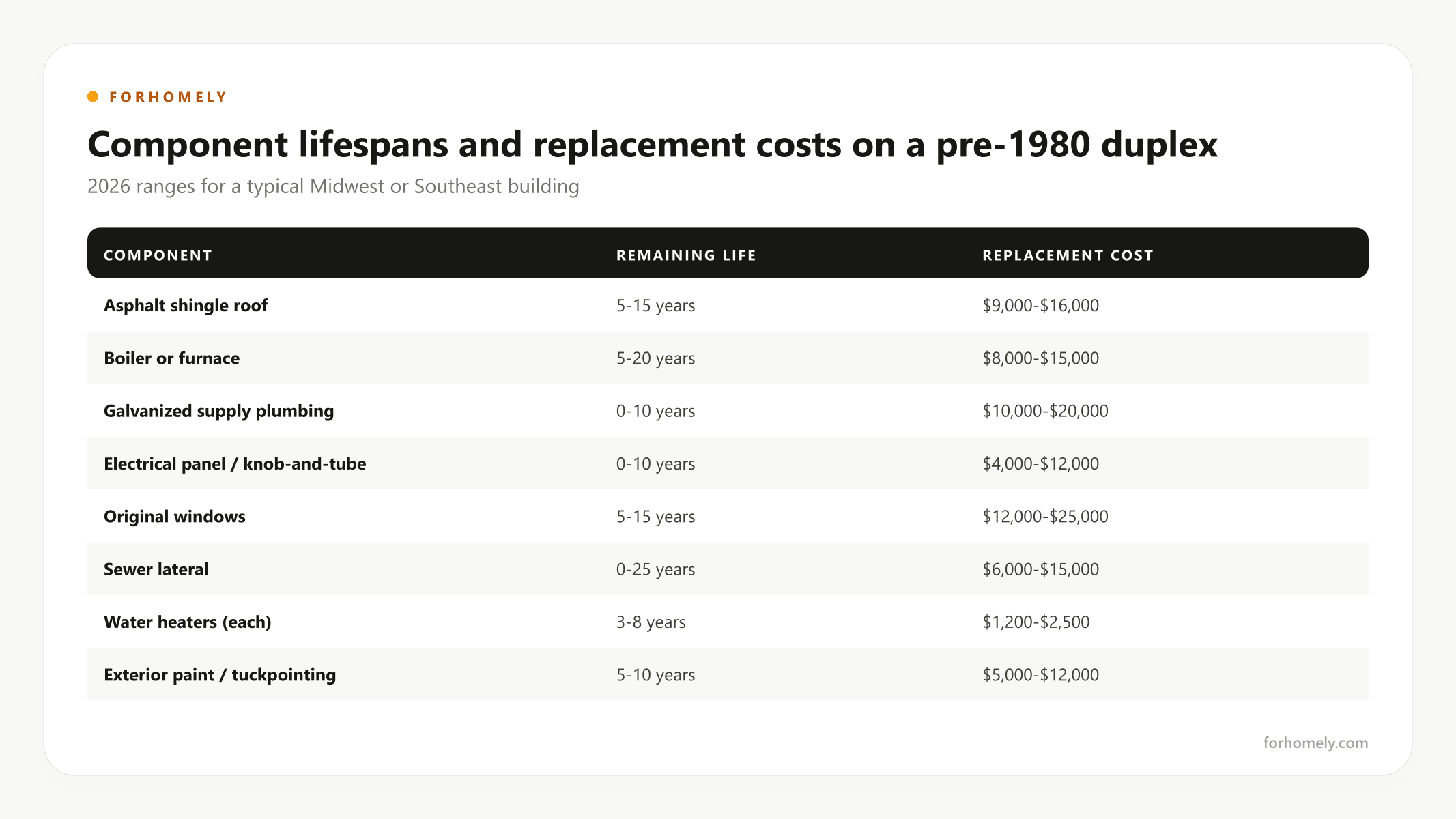

Component Lifespans in Pre-1980 Buildings

ComponentTypical Remaining LifeReplacement Cost (duplex)
Asphalt shingle roof5-15 yrs remaining$9,000-$16,000
Boiler / furnace5-20 yrs$8,000-$15,000
Original galvanized plumbing0-10 yrs$10,000-$20,000 (repipe)
Knob-and-tube or old panel0-10 yrs$4,000-$12,000
Original windows5-15 yrs$12,000-$25,000
Sewer lateral (clay/cast iron)0-25 yrs$6,000-$15,000
Water heater (each)3-8 yrs$1,200-$2,500
Exterior paint/tuckpointing5-10 yrs$5,000-$12,000

Three Budgeting Methods

Method 1: Percentage of Gross Income (Simple)

Reserve 8-12% of gross scheduled income for buildings over 40 years old; 5-8% for newer stock. A duplex grossing $38,400 reserves $3,000-$4,600/year. Easy to apply, blind to the building's actual components.

Method 2: Per-Unit Per-Year (Quick)

Reserve $250-$400 per unit per year for pre-1980 buildings ($600-$1,600/year for a fourplex). Better than nothing; ignores component age.

Method 3: Component-Based Reserve Study (Accurate)

List each major component, its remaining life, and cost — then fund the annual equivalent:

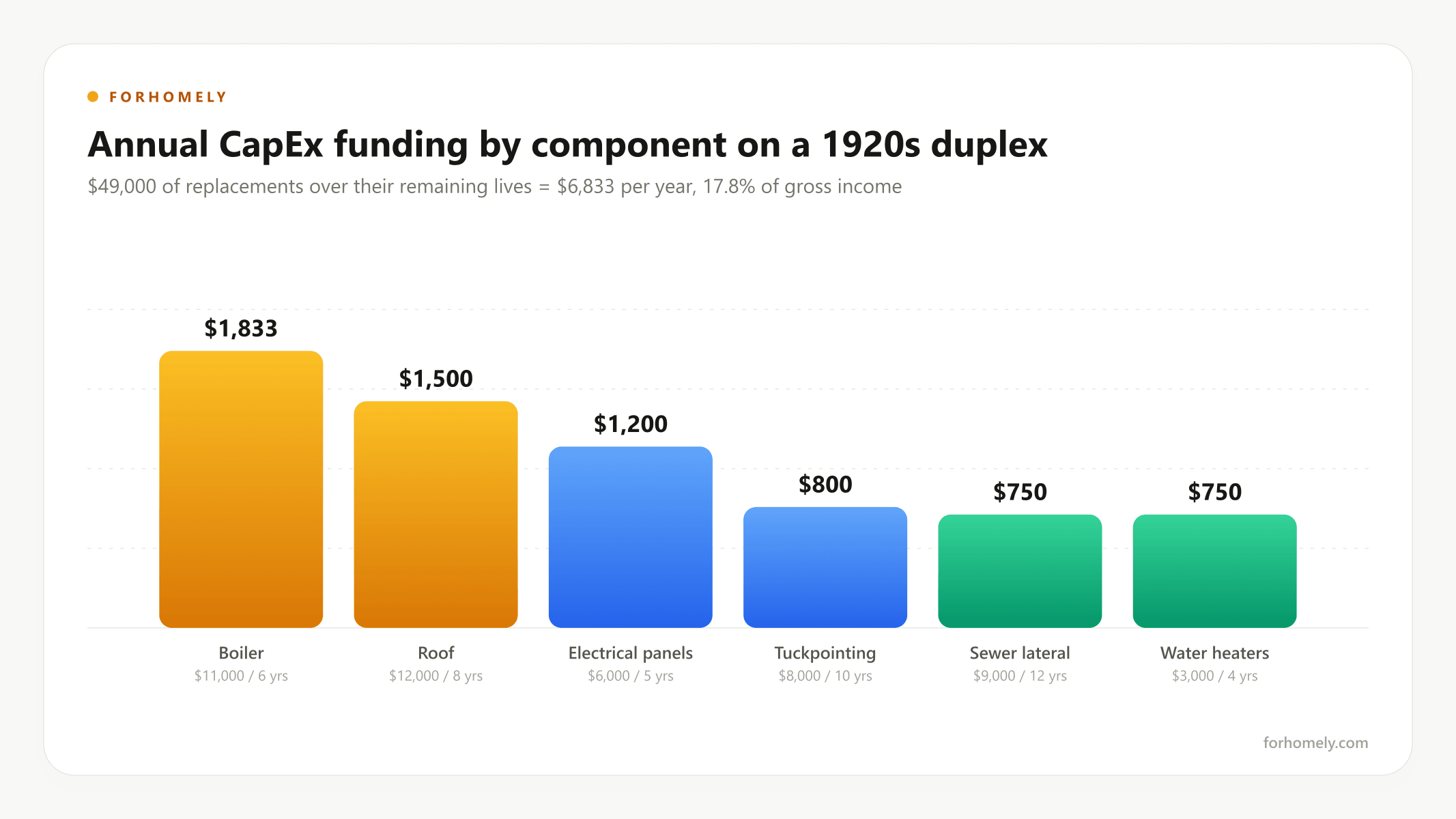

Worked example — 1920s duplex, $38,400 gross income:

ComponentCostRemaining LifeAnnual Funding
Roof$12,0008 yrs$1,500
Boiler$11,0006 yrs$1,833
Sewer lateral$9,00012 yrs$750
Electrical panel upgrade ×2$6,0005 yrs$1,200
Water heaters ×2$3,0004 yrs$750
Exterior tuckpointing$8,00010 yrs$800
Total$49,000$6,833/year

That is 17.8% of gross income — far above the 8-12% rule of thumb, and it is the honest number for this building. This is precisely why "1% rule" buildings with original mechanicals underperform: the CapEx load eats the margin.

The Pre-Offer CapEx Inspection Checklist

Before buying any pre-1980 2-4 unit property, get answers on:

  1. Roof age (permit records or seller disclosure) and any active leaks
  2. Heating system age — serial numbers date most boilers
  3. Electrical service: panel amperage, knob-and-tube presence, aluminum wiring
  4. Plumbing material: galvanized supply lines are near end-of-life
  5. Sewer scope: a $250 camera inspection can reveal a $12,000 lateral problem
  6. Foundation and tuckpointing condition
  7. Windows: original single-pane windows drive both CapEx and utility costs

Every item found is either a price reduction, a seller credit, or a line in your reserve plan.

Where to Hold the Money

Keep reserves in a high-yield savings account or money market fund — liquid and safe. Do not invest CapEx reserves in the stock market: roofs do not wait for bull markets to end. A separate account per property keeps multi-property accounting clean.

Model It Properly

The Multifamily Cash Flow & NOI Calculator includes a dedicated CapEx reserve percentage input, so your NOI, cash flow, and cash-on-cash return reflect the true cost of owning an older building — not the fantasy version the seller's pro forma shows.
